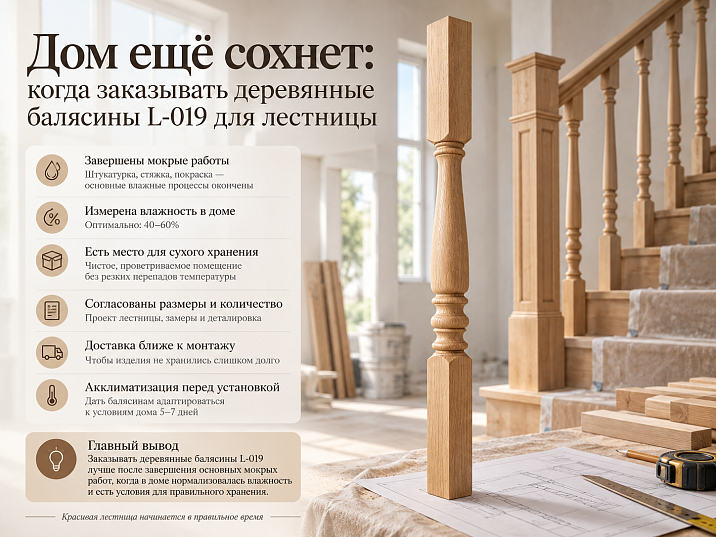

- Wooden balusters L-019: what to agree on before finishing renovations
- Ordering balusters and delivering them to the house are different decisions
- Is the house ready to accept wooden balusters after wet work
- Where to deliver L-019 if the site is not ready yet
- Beech, oak, and finishing: what must be decided before ordering L-019
- Production time for L-019 balusters: building a schedule from house readiness
- Price of L-019 and costs that arise with early purchase
- How to place and accept an order for wooden balusters L-019
- Questions before purchasing wooden balusters
- Can I order L-019 while the screed is drying, and the quantity is still preliminary?
- Is it mandatory to receive the balusters immediately after production?
- Can L-019 be stored in an unheated house if it is warm there in autumn?
- Does painting under 'Prestige' include enamel if the order additionally specifies 'under enamel'?
- Who should accept the products if the payer and the finishing workshop are different parties?
- What expenses should be clarified if the workshop agrees to accept the batch earlier than its turn?
- How to coordinate installation if the finisher has not yet chosen the coating?
- What to do if wet work has dragged on after the order has already been shipped?
Balusters L-019 are already in the staircase project, but the walls are still being plastered, the screed is being poured, or the bathroom is being redone in the house. I want to buy the set in advance so as not to stop installation later. However, along with the order, a second question arises: where will the parts be located between production and installation?
The order can be coordinated until the repair is completed. It is reasonable to start production when the execution, quantity, and delivery route are confirmed; bringing wooden products to the site is appropriate when a suitable room is prepared. If there is no place to store the batch, the issue of acceptance by the workshop or another shipping date is resolved first. Such conditions must be confirmed separately by the seller.
This allows Buy wooden balusters without relying on random free space at the construction site. Below is the procedure for one selected model: from specification to handover to the installer. It does not replace the fence project and does not set a universal drying time for the house.
Wooden balusters L-019: what to coordinate before the repair is completed
L-019 is a turned wooden baluster with dimensions A × B = 1000 × 40 mm. The card features beech and oak, with a "Prestige" sanding quality. As of September 5, 2026, one beech piece costs 2,050 ₽, and an oak piece costs 3,490 ₽.1
Before buy wooden baluster L-019, transfer the selected execution to the request. The entry "wooden balusters, twenty pieces" is not enough: the seller, painter, and installer must have matching designations for the material and surface preparation.
| What is already decided | What else to clarify | Who confirms |
|---|---|---|
| Model L-019, 1000 × 40 mm | Part matches fence design | Staircase designer or manufacturer |
| Need one wood species | Beech or oak for the entire batch | Customer and finisher |
| Prestige sanding | Glue joint grade and intended coating | Seller and finisher |
| There is a design quantity | Final number of parts and purpose of each group | Specification author |
| Installation is planned after renovation | Receiving location, recipient, and agreed shipment | Customer, seller, receiving party |
The 1000 mm size refers to the product, not automatically to the height of the installed railing. The length after fitting and mounting points are checked against the project. The quantity is also taken from the approved specification: a photo of the flight does not replace information about the landing, turns, and element placement.
If the staircase configuration is still changing, separate the preliminary calculation from the consent to manufacture. Send the manager the current drawing with a date and version number, rather than several mismatched images from the correspondence. In the request, it is useful to write directly: "The quantity is preliminary, launch after confirmation of the specification." This is a proposed wording for approval, not a description of the seller's automatic workflow.
While the house is drying, you can choose a finisher, prepare a color sample, and clarify the transport route. These decisions do not require keeping the entire batch on site.
Separately check whether one of the parts has been assigned as a control sample for painting or fitting. If out of a conditional twenty pieces, one is given to the painter for trials, then nineteen will arrive for installation without its return. This is not grounds to automatically buy a spare: first clarify whether the sample will remain suitable for project use and who is responsible for returning it to the set.
Ordering balusters and bringing them to the house are different decisions
One purchase contains several independent events: approval of the order composition, payment, manufacturing, shipment, receipt, finishing, and installation. An error occurs when the word "ready" is used to denote all these stages at once. Production readiness means the availability of manufactured parts, but not the readiness of your house to accept them.
The STAVROS page describes order placement, payment methods, receipt via transport companies, courier delivery, and pickup. When placing an order, the characteristics of the products, quantity, and contact details are specified.2 Before payment, study the payment and delivery terms for balusters and separately agree on a non-standard scheme.
Ask whether shipment on the selected date is allowed, whether storage until then is possible, how much it costs, and when the agreed period ends. Clarify whether the order can be sent directly to the finishing workshop, what recipient data is needed, and how the address and transport costs change upon rescheduling. The answer "we'll discuss when we manufacture" leaves the main decision open.
Record the agreement in correspondence or order documents: a specific date or the procedure for confirming it, address, recipient, cost of additional operations. Do not consider payment as confirmation of free storage or an unchanged price for any subsequent services.
When a purchase is premature: the project quantity is not approved, there is no suitable place, the workshop does not accept the batch, and late shipment is not agreed upon. In such a situation, it is more useful to obtain a commercial offer and clarify the terms of a future order. Buying parts just for the feeling that another repair item is closed is impractical.
Our factory also produces:
Is the house ready to accept wooden balusters after wet work
The STAVROS memo applies to wooden products before finishing and installation. The manufacturer recommends keeping surfaces dry, excluding contact with water, avoiding sharp temperature changes, and maintaining a storage temperature from +10 to +25 °C.3 These rules for storing wooden products before installation must be applied to a specific location, not to the whole house "on average."
Wood has the ability to exchange moisture with the environment; the manufacturer directly notes its sensitivity to room conditions.3 Therefore, completing the screed pour and stopping related wet processes are not the same event. The date the crew finishes work does not by itself confirm the room is ready for storage.
It is convenient to conduct the check together with the person responsible for the renovation. Determine which wet operations are completed specifically in the chosen area and whether they will resume after delivery. Inspect the placement location: check for leaks, splashes, damp substrate, or proximity to a tool washing area. Clarify whether the regime is maintained continuously, including nights and days without workers.
A room thermometer reading does not answer the question of wood moisture. A hygrometer measures air humidity, a moisture meter measures the corresponding material; their results cannot be substituted for each other. Ask the contractor to record which indicator is being checked, with which device, and for which decision. The required conditions for acceptance and subsequent work are agreed with the product manufacturer and the finisher.
Do not transfer production workshop indicators from information pages as a universal tolerance for construction. Do not assign a deadline like "two weeks after plastering" either: the request requires confirmed readiness of the premises, not a convenient calendar formula.
The practical boundary is an isolated finished room while renovation of other premises continues. This option can be considered after checking storage conditions and the path for bringing items in. But a closed door does not yet confirm isolation: if the room is regularly opened for workers to pass through, wet materials are stored in it, or heating is turned off, the initial assessment no longer describes the actual situation.
Another mistake is warming up a cold storage room only by the time the truck arrives. A measurement at the moment of unloading will show the temperature of that hour, not future conditions. Assign a person responsible for the premises until the parts are handed over further, and coordinate actions in case of heating shutdown or leaks. The check must end with the name of the responsible person and a decision "accept" or "change route."
Warehouse readiness and installation site readiness are checked separately. For example, a batch may be in a suitable room while the stairwell is still occupied by finishers. This allows accepting the products but does not justify scheduling the installation of the railing. The schedule needs two different marks: "storage location accepted" and "installation area ready." For each, a separate responsible person is indicated if different contractors make the decisions.
Get Consultation
Where to deliver L-019 if the site is not ready yet
Choose the location based on actual conditions and agreements. The name "garage," "workshop," or "guest room" guarantees nothing. For the order, it is useful to compare the following routes.
| Route | Who accepts | Where they place it | Who pays and delivers for installation |
|---|---|---|---|
| Prepared customer premises | Assigned recipient | In a pre-checked area | Customer specifies initial delivery and subsequent movement |
| Finishing workshop | Agreed employee | At a designated spot per workshop conditions | Order owner coordinates acceptance, storage, and transport after finishing |
| Another shipping date | Recipient on the new date | Location before dispatch is agreed with the seller | Costs and further route are included in the agreement |
Acceptance at the customer's site. Before payment, clarify the dimensions and weight of the packed batch, not just the size of one baluster. Check transport access, unloading capability, and the path to the placement location. Do not designate as the recipient a person who can only sign but does not know the order contents and has no access to the prepared room.
Delivery to the finisher. Obtain their consent to the specific quantity and date. In the workshop schedule, the start of painting may be set later than receipt, and storage until work begins may be charged separately. Provide the specification and sample in advance; agree on who inspects the items, reports discrepancies, and authorizes the start of finishing.
Rescheduling shipment. This route exists only upon seller confirmation. Immediately clarify the postponement limit and next steps if the renovation is delayed again. Do not substitute the agreement with a request to the carrier to "let it sit at the terminal for now": that is a different party and different terms.
When choosing, consider not only address proximity. Additional transport means another handover of the batch between people. Record the number of pieces, marking, and contact of the next recipient.
For acceptance in a separate room, compare two paths: through the finished entrance and through the work area. If the chosen route passes where materials are cut or mortars are moved, agree on a separate unloading window and a clear passage. A room cannot be considered accessible just because it is marked on the plan. Until a permanent stair railing is in place, the responsible party for the construction site must determine safe access organization. Balusters in packaging do not replace temporary railing.
If items pass through the workshop, assign a responsible person for packaging after finishing: shipping packaging is not necessarily suitable for a surface with a new coating without verification by the contractor.
Beech, oak, and finishing: what must be decided before ordering L-019
For this purchase, the choice of wood species starts with an agreed appearance, not with the assumption that more expensive timber will allow storage in an unprepared house. The oak option does not cancel the requirements for the acceptance location.
At the manufacturer, the designations "under enamel" and "under tinting" refer to the grade of lamella splicing. In the first case, lamellas may differ in color and pattern; the second implies selection for translucent finishing, but not absolute identity of all parts. "Prestige" indicates sanding quality, not applied paint.4 Before ordering, it is worth select wood for enamel or tinting together with the coating contractor.
In the request, split into three lines: wood species, veneer grade, finish. The wording "beech, Prestige, white" does not explain whether you are buying a prepared part with subsequent painting by an external craftsman or separately agreed on coating application by the seller.
The sample should show the selected wood species and finishing system. Evaluate it next to the handrail and step under the lighting of the future staircase. A screen photo is suitable for discussing color direction but does not replace an agreed physical sample. Sign it and indicate in the order where it is stored.
STAVROS has Tips for finishing wooden products, including preparation and coating application.5 This is an informational page, not confirmation of an included service. Specific materials, technological hold times, and the moment of readiness for packaging are set by the contractor of the selected finish.
The sequence of fitting and painting is determined with them in advance. If the installer requires operations on ends or mounting areas, they must be accounted for before handing the batch to the painter. Otherwise, after delivery of finished painted parts, an unplanned return for rework appears.
Production time for balusters L-019: we schedule based on house readiness
The FAQ on the product card states an average production time for custom orders of 5–10 business days.1 This is a production guideline, not a promise to deliver the batch within ten calendar days after the first inquiry. For your order, clarify the event from which the countdown starts: specification confirmation, payment receipt, or another agreed condition.
It is more convenient to build the schedule backwards from the desired installation. First, the installer and the person responsible for repairs determine the acceptable date for the work. Then the finisher states by what time they need to receive the products to complete the preparation and coating. After that, transportation and production readiness are coordinated.
| Stage | Date or period to fill in | Who confirms | What should be ready |
|---|---|---|---|
| Fence installation | ___ | Installer and person responsible for the site | Room, base, and kit according to the project |
| Handover after finishing | ___ | Finisher | The coating allows packaging, transportation, and subsequent operations |
| Acceptance before finishing | ___ | Receiving party | Place for the party and agreed task |
| Transportation | ___ calendar days; dates ___ | Seller and carrier | Address, recipient, unloading possibility |
| Production readiness | ___ working days; date ___ | Seller | Confirmed execution and quantity |
| order confirmation | ___ | Customer and seller | Agreed specification and payment terms |
Do not add production working days to transportation calendar days as if they were the same units. First convert agreed stages into dates considering the schedules of the performers. The duration of finishing and its sequence are filled in separately: the availability of a free installer does not mean that the painter will be able to finish by the same day.
Provide a checkpoint before shipment. For example, the person responsible for repairs confirms the readiness of the receiving location, and the customer informs the seller of the final address according to the agreed procedure. This organizational condition must be accepted by both parties in advance; simply adding a line to your own calendar does not obligate anyone.
If the repair deadline has shifted, check the status of the order. Before dispatch, discuss changing the date or route with the seller. After handover to the carrier, clarify possible actions with the carrier's involvement. After arrival at the workshop, check whether the storage duration and pickup date are changing. These situations have different costs and different people who can change the plan.
Do not schedule installation for the day after the estimated delivery without agreeing on acceptance and finishing. Even if the calendar shows the vehicle can make it, the schedule remains incomplete when a kit check is not planned. The agreed buffer time should be tied to specific operations and route risks, not set as an arbitrary percentage.
Price of L-019 and costs that arise with early purchase
We will show the budget on a conditional batch of twenty items. This is an example of cost, not a recommendation for the number of balusters for your staircase. Prices are taken from the L-019 card as checked on September 5, 2026.1
| Execution 1000 × 40 mm, "Prestige" | Calculation | Cost of balusters only |
|---|---|---|
| Beech | 20 × 2 050 ₽ | 41 000 ₽ |
| Oak | 20 × 3 490 ₽ | 69 800 ₽ |
The difference is 28,800 ₽. It relates to the chosen wood species, not to the ability to place parts on a damp site. Substituting a more expensive execution for a storage decision is not allowed.
To compare routes, request an estimate with separate line items: balusters; other components per the project; preparation and coating; initial delivery; agreed storage; packaging after finishing; second transport; installation. An unknown amount remains "per commercial offer," not turning into zero.
Early and late purchase are compared with the same scope of work. If the first option includes storage and two transports, and the second only delivery to the site, check where finishing is done in the second case and whether the route to the workshop is included. Otherwise, the cheaper option may simply be an incomplete estimate.
For planning, use a simple equation: total costs = products + necessary components + finishing + agreed logistics + storage + installation. It helps to see missed services, but does not predict their price.
Before buy components for a wooden staircaseCompare the composition with the fence project. Handrails, posts, and provided fasteners should have their own line items and timelines. The availability of the entire batch L-019 does not mean the full set is ready for installation.
Do not justify an early order by assumed price increases. Economic sense appears when the actual conditions of both options are known. Before payment, re-check the current price of the selected execution and the total amount of the offer.
How to place and accept an order for wooden balusters L-019
A good request answers two questions: what to manufacture and where to deliver the result. Below is a text that can be filled out and sent to the seller. Fields with unknown conditions are intentionally left open.
Please calculate an order for wooden balusters L-019, turned, size A × B = 1000 × 40 mm. Material: ___. Sanding: "Prestige". Glue grade: ___. Quantity per approved specification: ___ pcs.; project version and date: ___.
Planned finishing: ___. Contractor: ___, contact: ___. Agreed sample: ___. Please indicate which works and materials are included in the offer and which are performed separately.
The following wet works are ongoing at the site: ___. Estimated readiness date of the acceptance area: ___. Before shipment, it is confirmed by: ___. Please agree on the possibility of the chosen schedule, storage conditions before shipment, if required, and the procedure for changing the date.
Delivery address: ___. Recipient and phone: ___. Acceptance time, transport access, unloading: ___. Placement location after receipt: ___. Who delivers the products after finishing to installation: ___.
Please confirm the price, availability or production time, its start date, agreed shipment date, transport cost, packaging details, and list of additional expenses. If renovation is postponed, changes are coordinated with: ___.
When a response is received, check not only the final amount. It should resolve critical uncertainties: which option is ordered, who accepts the batch, and what happens if the date changes. The phrase "delivery upon readiness" requires clarification—readiness of production or of the receiving premises.
Upon receipt, verify documents, markings, quantity, and execution. Inspect packaging and accessible surfaces of the products, record visible chips, cracks, traces of moisture, or other discrepancies. Take a general photo of the batch, photos of markings, and individual shots of detected damage. Do not start painting or adjusting a disputed part until discussing with the seller: the original condition must be preserved for the investigation.
If the recipient is a workshop employee, provide them with a copy of the specification and the customer's contact in advance. It is useful to separate the messages "goods received" and "batch verified, comments as follows." The first means completion of transport, the second—the result of inspection. Permission to proceed with finishing is given after the agreed check, not automatically after signing upon receipt.
Before handing over to the installer, re-verify the quantity and condition of already finished parts. Preserve group designations if the project distinguishes elements of the flight and landing. Installation solutions, cutting, and fastening are performed according to the approved scheme; the order article does not replace it.
The order is ready to be finalized when the product, quantity, finishing contractor, recipient, and agreed path to installation are determined. The next step is— Specify the quantity of L-019 and agree on the shipment date.
Questions before purchasing wooden balusters
Can I order L-019 while the screed is drying, if the quantity is still preliminary?
You can request a quote and discuss timelines, but you should not mix a preliminary inquiry with confirmation of a batch. First, the project author specifies the number of parts. If a single sample is needed to check color or shape, it is discussed as a separate purchase with its own purpose, not as a basis for ordering the rest based on an approximate estimate.
Is it mandatory to receive the balusters immediately after production?
The allowable storage duration at the seller's premises cannot be derived from the average production time. Clarify it before ordering. If a postponement is agreed upon, record the date, cost, and contact of the person confirming shipment. Also ask what will be required in case of another delay: the initial agreement does not necessarily extend to an indefinite additional period.
Can L-019 be stored in an unheated house if it is warm there in autumn?
The conditions of the entire intended storage period are assessed, not the weather on the day of receipt. Without confirmation of a stable regime, such a place cannot be considered suitable. When renovation may extend into the cold season, immediately consider another premises or a different delivery schedule. The name of the season does not replace checking the location against the manufacturer's guidelines.3
Does painting come included in "Prestige" if the order additionally states "under enamel"?
No, these designations by themselves do not confirm an applied coating: they refer to sanding and the grade of lamination.4 For painting, a separate agreed line item with the contractor, materials, and price is needed. Ask to see the composition of the offer, and do not infer the configuration from the word "ready" in correspondence.
Who should accept the products if the payer and the finishing workshop are different parties?
Inform the seller in advance of the actual recipient and clarify the details or documents required for issuance. Within the workshop, assign an employee to verify the batch and report the result to the payer. It is better to explicitly distribute payment for the order, physical receipt, and permission to begin finishing: these are different actions, even if performed by one person.
What costs should be clarified if the workshop agrees to accept the batch earlier than its turn?
In addition to storage, ask about unloading, movement within the workshop, repacking, and removal. Clarify the tariff unit and billing period: a "storage week" without a start date does not give an exact amount. Obtain the conditions for freeing up space and the procedure for agreeing on an additional period, so that a delay of the object does not leave the workshop without a solution.
For partial issuance, clarify whether the paid storage volume decreases. Receiving part of the batch may require separate packaging and a trip; the cost of these operations should be compared with the actually reduced storage expenses, rather than considering partial removal as obviously beneficial.
How to coordinate installation if the finisher has not yet chosen the coating?
First, the finishing system and sequence of operations are determined. Until then, the completion date of finishing remains preliminary. The installer is given it with exactly this status. Do not replace an unknown technological hold with a familiar timeframe from another project: the schedule should be based on the selected materials and the contractor's confirmation, not only on the desired move-in date.
What to do if wet work has already been delayed after the order was sent?
Clarify the location of the cargo and possible changes with the seller and carrier. Simultaneously confirm an alternative address and the recipient's readiness. Do not send a vehicle to the workshop without its consent and do not count on free waiting. After the decision, update the overall schedule, costs, and contacts so that the finisher and installer do not continue working according to the old version.
